QC case study: a stretch-pants run we rejected, had re-produced and re-inspected before it shipped.

At the in-process inspection on 18 February 2026, five of the eight defect types in our production contract were present and the size grading had not been applied. We rejected the first run. The factory re-produced it, we re-inspected the new lot on 25 February 2026, all six findings had cleared, and only then did it ship. Extra QC charge to the buyer: $0.

Inspected on site by the Dawn Sourcing QC team in Yiwu, China · Released by Fred Lee · Page updated

  1. 18 Feb 2026First run: rejected5 of 8 contract defect types found
  2. NextReturned & re-producedDefective units pulled; grading corrected, not reworked
  3. 25 Feb 2026Re-inspectedAll six findings cleared, seven days after the first check
  4. VerdictApproved to shipThe buyer received the corrected lot, not the first run

What order was this, and how was it inspected?

Product
Stretch pants — long & shorts
Colorways · sizes
Black, gray, khaki, charcoal · M–5XL
Stage
IPQC — in-process, first production run
Inspected by
Dawn Sourcing QC inspector, in person on the factory floor
Sampling standard
ISO 2859-1 (AQL), General Inspection Level II
AQL critical / major / minor
0 / 2.5 / 4.0
Outcome
Rejected, re-produced, re-inspected, shipped
Withheld
Buyer, PO number, style, order quantity, factory

This is the public, anonymized version of the report. Defect findings, measurements and dates are as recorded; only identifiers are withheld.

What did the inspection find?

We inspect against eight defect types that are written into our production contracts, so a finding is a contractual defect the factory has to correct — not a matter of opinion. Five of the eight were present.

  1. 1SewingFound

    Pocket seams ran in the wrong direction — left and right mismatched on every colorway. Rise seam misaligned on almost every sample checked. Hem and belt sewing defective. Poor finishing at the hem, side pocket and belt.

  2. 2FabricFound

    Fabric dents and press marks. The cut line at the hem was not consistent.

  3. 3Dyeing & colorNot raised

    No finding on this inspection.

  4. 4MeasurementFound

    Left and right legs came out at different lengths, total length was inconsistent between colorways, and the shorts were cut short on thigh and length. Gray M and L measured identically — the size grading had not been applied.

  5. 5Print & embroideryN/A

    Not applicable to this style.

  6. 6TrimsFound

    Belt punching defective.

  7. 7ContaminationFound

    Foreign matter sewn into seams. Heavy contamination on khaki and charcoal, general soiling throughout.

  8. 8PackingNot reached

    The goods never passed to packing.

Contract clause: any defect arising from a specification changed without the buyer's prior written approval is the factory's responsibility to correct.

Why was the whole run rejected instead of sorted?

Because the faults were in the run, not in a few units. Pocket direction was wrong on every colorway and the rise seam was misaligned on almost every unit checked. Sorting out bad pieces only works when defects are isolated; here the pattern and grading themselves were wrong, so the lot was rejected under the contract defect list.

ClassMeaningAllowedFoundResult
CriticalUnsafe or unsellable; regulatory failure00Pass
MajorWould cause a return, complaint or markdown—5 of 8 typesReject
MinorVisible deviation, unlikely to be rejected———

Lot size and sample counts are withheld with the order quantity, so AQL accept/reject numbers are not shown. The rejection rested on the contract defect list, not on a sample count alone.

What was done about each defect?

DefectScopeWhat we didRe-inspection
Pocket seam direction wrong, left/right mismatchedAll colorwaysDefective units pulled and returned; re-production orderedPassed
Belt sewing defectiveRecurringReturned; re-produce wherever rework could not hold the ship datePassed
Rise seam misalignedNearly all samplesReturned to the factory with the defective unitsPassed
Measurement and grading errorsMultiple sizesRe-production ordered — grading corrected, not reworkedPassed
Foreign matter in seams, soilingKhaki, charcoalReturned to the factoryPassed
Belt punching defectiveRecurringReturned to the factoryPassed

Photos from the first inspection

Taken on 18 February 2026, in the state the goods were rejected in. Identifiers are withheld; nothing else is altered.

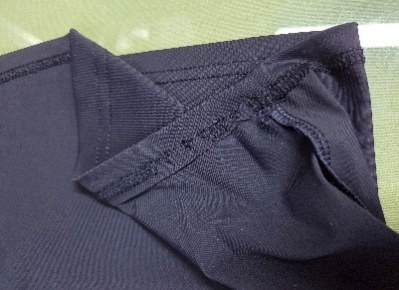

Pocket seam sewn in the wrong direction on stretch pants
Pocket seam sewn in the wrong direction

Poor finishing at a sewn seam
Poor finishing after sewing

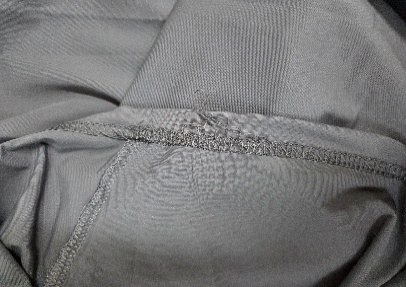

Defective waistband seam
Defective waistband seam

Defective hem seam
Defective hem seam

Uneven gathering at the waistband
Uneven gathering at the waistband

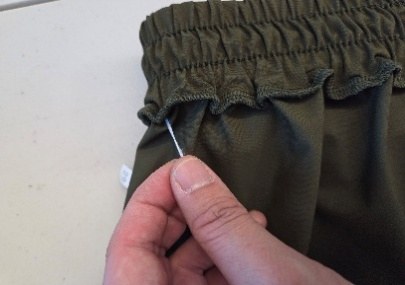

Defective belt punching
Defective belt punching

Soiling on the fabric face
Soiling on the fabric face

Fabric puckering along a seam
Fabric puckering along a seam

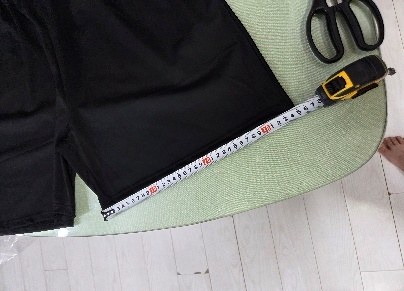

Shorts length measured against a tape
Shorts length, measured with a tape

What did the inspection cost the buyer?

ItemDetailCost
In-process inspection (IPQC)Included in the unit price$0
Third-party pre-shipment inspectionNot required — caught in-process$0
Lab test / 100% inspectionNot required at this stage$0
Extra QC charge to the buyerInspection is part of the unit price$0

Inspection is part of the unit price on every order, including third-party inspection or lab tests when an order needs them, so a buyer never receives a separate QC bill. How our four QC checkpoints work →

Final verdict

Approved to ship — after re-production and re-inspection.

Five of the eight contract defect types were present, and two of them — pocket seam direction and rise seam alignment — appeared across every colorway rather than in isolated units. Left and right legs came out at different lengths, and gray M and L came off the line at identical measurements, meaning the grading had not been applied at all.

The first run was rejected. Defective units were pulled and returned to the factory with the findings above, and the factory was told to re-produce rather than rework wherever rework would not hold the shipping date. Nothing from that run was released to the buyer.

The re-produced lot was inspected again before release. All six findings cleared and the goods shipped. That is the point of inspecting during production rather than after it.

Inspected by
QC inspector, Dawn Sourcing · 18 Feb 2026
Released by
Fred Lee, Dawn Sourcing · 25 Feb 2026, after re-inspection

Inspection and release are signed by different people, so whoever checks the goods is not the person who clears them to ship.

Questions about this inspection

What AQL standard was used?

ISO 2859-1 sampling at General Inspection Level II, with AQL 0 for critical, 2.5 for major and 4.0 for minor defects. The lot was rejected on the contract defect list because the faults ran through the whole run.

How long did it take from rejection to shipment?

The first inspection was on 18 February 2026 and the re-produced lot was re-inspected on 25 February 2026 — seven days later. It shipped after passing.

Did the buyer pay extra for this inspection?

No. The extra QC charge was $0. In-process inspection is included in the unit price on every order, and a third-party inspection or lab test was not needed because the problems were caught during production.

Does every order get an in-process inspection like this?

Yes. IPQC runs on every order during production, alongside incoming, final and pre-dispatch checks. See how we inspect apparel orders.
